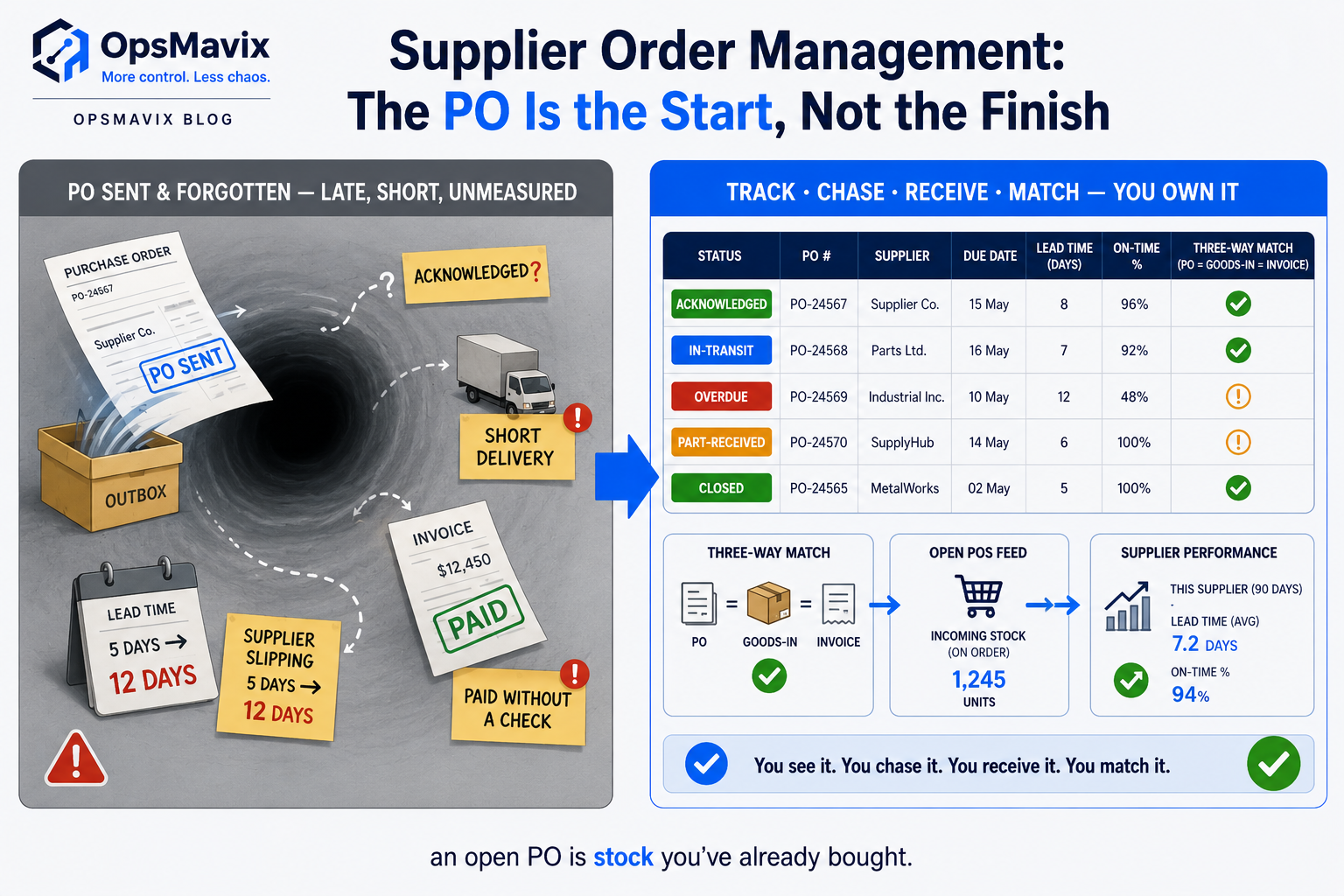

Supplier Order Management Software: Running the Inbound Side End-to-End
Supplier order management software isn't about raising a purchase order — it's about everything that happens after you send it. The acknowledgement that never came, the lead time nobody's tracking, the delivery that turned up short, the invoice that doesn't match what you ordered. Creating the PO is one document; managing the supplier and the inbound order over time is the capability that actually keeps stock on the shelf. Here's what that capability has to do, and where a right-sized system beats both the spreadsheet and the ERP.
Supplier order management software manages the conversation with suppliers about each order you place: how the order reaches them, what they confirm, how dates and quantities change on either side, and how deliveries from several suppliers line up for the same need. It sits between raising a purchase order and receiving the goods, and its job is to keep your records and your suppliers’ commitments in agreement.
The practical problem is that this conversation usually runs through inboxes. One supplier replies with a revised date in an email thread, another uploads a confirmation to its own portal, a third sends nothing until the lorry arrives. Your planner then decides what to promise customers from a purchase order that no longer reflects what the supplier agreed. This guide covers the supplier-facing side of the process: channels, confirmations, schedule changes and multi-supplier coordination.

Each consignment depends on a supplier commitment that someone has to confirm and keep current. Illustrative photograph, not an OpsMavix project.
Image credit: Frank McKenna, Unsplash License. Resized only.
Key Takeaways
- Supplier order management covers the exchange with suppliers after an order is placed, not the internal approval of the order.
- Match the channel to the supplier: email for occasional suppliers, a portal for regular ones, EDI where volumes and partner requirements justify it.
- Compare every supplier confirmation with the order line by line, and approve or reject differences before they become your plan.
- Treat schedule changes as versioned records in both directions, with the reason, the requester and the response kept.
- When one need depends on several suppliers, the latest confirmed date sets the real date, so expedite the constraint first.
- Share a small, clearly defined performance record with suppliers and review it with them regularly.
In this guide:
- 1. Understand What Supplier Order Management Covers
- 2. Choose How Each Supplier Exchanges Orders
- 3. Turn Supplier Confirmations Into Usable Records
- 4. Manage Schedule Changes in Both Directions
- 5. Coordinate Orders Across Several Suppliers
- 6. Use Shipping Notices and Receipts to Close the Loop
- 7. Share Performance Data With Suppliers
- 8. Compare Approaches and Pilot With a Few Suppliers
- Frequently Asked Questions
- How OpsMavix Can Help
1. Understand What Supplier Order Management Covers
Separate the supplier conversation from neighbouring jobs
Several OpsMavix guides cover the stages around this one. Use them to avoid buying or building the same capability twice.
| Job | Main question | Guide |
|---|---|---|
| Raising and approving the PO | Who may commit spend, and on what terms? | Purchase order software and purchase order management software |
| Following open orders internally | What is open, due, overdue or part received? | Purchase order tracking system |
| Agreeing each order with the supplier | What has the supplier committed to, and what has changed? | This guide |
| Measuring supplier lead time | How long does each supplier really take? | Supplier lead time management |
| Checking invoices before payment | Does the bill agree with the order and the receipt? | Three-way matching |
The tracking guide looks inward at your list of open lines. This guide looks outward at the exchange that keeps those lines accurate.
The records that matter
A supplier order management process needs a few linked records for every order:
- The order version the supplier received, with its date and channel.
- The supplier’s response: accepted, rejected or accepted with changes.
- Any change requests from either side, with the decision on each.
- Shipping notices or dispatch confirmations, where suppliers provide them.
- The receipt recorded at goods-in.
When those records sit together, a buyer can answer “what did the supplier agree to, and when?” without searching a mailbox.
2. Choose How Each Supplier Exchanges Orders
Three common channels
Most businesses use more than one channel, because suppliers differ in size and capability.
| Channel | How it works | Fits | Limitations |
|---|---|---|---|
| Email with PDF orders | You send the order; the supplier replies in free text or a marked-up PDF | Occasional or small suppliers | Replies must be read and keyed in by hand; versions are easy to confuse |
| Supplier portal | Suppliers log in to view orders and respond in structured fields | Regular suppliers willing to use your system | Suppliers juggling many customers’ portals may respond slowly; needs user support |
| EDI | Systems exchange standard electronic messages directly | High volumes or partners who require it | Mapping, testing and provider costs; each partner may have its own guidelines |
What EDI messages cover
EDI standards define message types for each step of the conversation. The X12 supply chain flow lists, among others, the 850 Purchase Order sent by the buyer, the 855 Purchase Order Acknowledgment returned by the seller, the 860 Purchase Order Change Request (Buyer Initiated), the 865 Purchase Order Change Acknowledgment/Request (Seller Initiated), the 856 Ship Notice/Manifest and the 810 Invoice. Other standards are used in other regions and sectors, so confirm which ones your suppliers support.
The message set is a useful checklist even if you never use EDI. A portal or an email process should capture the same events: order, acknowledgement, change in both directions, shipment and invoice. The sales-side equivalent is covered in the guide to EDI order processing for wholesale distributors.
Assign a channel per supplier
Record the agreed channel on each supplier record, with a named contact and the expected response time. A simple rule set works well:
- Suppliers you order from rarely: email, with responses keyed into structured fields by the buyer.
- Regular suppliers: invite them to a portal, and keep email as a fallback.
- Suppliers that already exchange EDI with customers: test whether EDI is practical for your volume.
3. Turn Supplier Confirmations Into Usable Records
Three possible responses
A supplier can accept an order, reject it or accept it with changes. Packaged systems often model this explicitly. Microsoft’s documentation for Dynamics 365 vendor collaboration describes vendors accepting, rejecting or accepting with changes, changing dates or quantities on lines, splitting lines across different dates or quantities, and proposing substitutes. It also states that vendors cannot change pricing or charges in that response, but can use notes to suggest such changes. Check the exact behaviour of any product you consider.
Whatever the tool, the response should become structured data on each line, not a sentence in an email.
Compare the confirmation with the order
Before a confirmation becomes your plan, compare it with the order line by line. Agree a short list of differences that need a buyer’s decision:
| Difference | Typical decision | Who decides |
|---|---|---|
| Later date | Accept, reschedule dependent work or source elsewhere | Buyer with planning |
| Lower quantity | Accept the balance as a backorder or cancel it | Buyer |
| Higher price | Accept, negotiate or reject, within approval limits | Buyer, with approver above limit |
| Substitute item | Approve technically, then commercially | Buyer with quality or engineering |
| Split delivery | Accept if each part is useful on its own | Buyer with planning |
HYPOTHETICAL worked example: a confirmation with changes
Assume a buyer sends a four-line order and the supplier responds with changes. All figures are hypothetical and exclude VAT.
| Line | Ordered | Confirmed | Unit price ordered | Unit price confirmed |
|---|---|---|---|---|
| 1. Brackets | 500 on 4 November | 500 on 4 November | £1.80 | £1.80 |
| 2. Hinges | 300 on 4 November | 250 on 4 November | £2.40 | £2.40 |
| 3. Fixings | 1,000 on 4 November | 1,000 on 10 November | £0.15 | £0.15 |
| 4. Handles | 400 on 4 November | 400 on 4 November | £3.10 | £3.20 (proposed in notes) |
The original order value is (500 x £1.80) + (300 x £2.40) + (1,000 x £0.15) + (400 x £3.10) = £900 + £720 + £150 + £1,240 = £3,010.
If every change is accepted, the confirmed value is £900 + (250 x £2.40) + £150 + (400 x £3.20) = £900 + £600 + £150 + £1,280 = £2,930. The total falls by £80, yet two lines got worse: 50 hinges are missing and the handles cost £40 more (400 x £0.10). A check on the order total alone would miss both. Line 3 is now six days late before anything has shipped.
4. Manage Schedule Changes in Both Directions
Buyer-initiated changes
Your own demand moves. A customer delays an order, a forecast drops or a job is brought forward. Send the change to the supplier as a new version of the order, not as an informal message, and keep the earlier version. Record the reason, because a supplier asked to pull in deliveries every month will reasonably ask why.
Supplier-initiated changes
Suppliers revise dates after confirming, for example when their own materials or capacity slip. Treat each revision as a request that needs your decision, and update the line’s confirmed date only once it is accepted. Keep the history: repeated revisions are a measure of reliability in their own right.
HYPOTHETICAL worked example: a negotiated reschedule
Assume a line for 600 units is confirmed for 3 November. Demand falls, so the buyer asks to split it.
| Version | Raised by | Content | Outcome |
|---|---|---|---|
| v1 | Buyer | 600 units on 3 November | Accepted by supplier |
| v2 | Buyer | 300 on 3 November, 300 on 17 November | Supplier proposes change |
| v3 | Supplier | 300 on 3 November, 300 on 24 November | Accepted by buyer |
In this hypothetical case, the buyer’s planned stock on 17 November is now 300 units lower than v2 assumed, and the second delivery arrives 7 days after the date requested (24 minus 17). If the business sells a hypothetical 20 units a day from this line, the remaining 300 units from the first delivery cover 300 / 20 = 15 days, so stock from 3 November lasts until about 18 November. That leaves a gap of roughly 6 days before the 24 November delivery unless other stock or an earlier date covers it. The planner sees this only if v3, not v2, drives the stock projection.
Change control checklist
- Every change creates a new version with a number, date, requester and reason.
- The supplier’s response is recorded against the version it answers.
- Confirmed dates change only when a change is accepted.
- Stock projections and customer promises use the latest accepted version.
- Changes above agreed value or date thresholds go to an approver.
5. Coordinate Orders Across Several Suppliers

Deliveries from several suppliers often have to meet before one job or customer order can move. Illustrative photograph, not an OpsMavix project.
Image credit: Matthew Jackson, Unsplash License. Resized only.
Group orders by the need they serve
Many needs depend on several suppliers: a production build, a kit, a project phase or a large customer order. Link each purchase order line to the need it serves, so you can see every supplier involved in one view. Subcontracted operations add another layer; the guide to subcontract manufacturing tracking covers parts sent out and returned.
HYPOTHETICAL worked example: the constraint supplier
Assume an assembly needs components from four suppliers, followed by 2 days of assembly.
| Supplier | Component | Confirmed date |
|---|---|---|
| A | Frames | 4 November |
| B | Motors | 6 November |
| C | Control boards | 12 November |
| D | Packaging | 5 November |
The assembly cannot start until all four components have arrived, so the earliest start is the latest confirmed date: 12 November. Adding 2 days of assembly gives a completion date of 14 November. Expediting supplier A, B or D changes nothing. If supplier C could bring its date forward to 7 November, the start would move to the next latest date, 7 November, and completion to 9 November, five days earlier.
The same view shows the reverse case. If supplier C cannot improve its date, frames due on 4 November will wait 8 days before use (12 minus 4). The buyer may ask supplier A to deliver later, which frees storage space and defers cash.
Coordination checklist
- Each order line is linked to the need it serves.
- The view highlights the latest confirmed date as the constraint.
- Unconfirmed lines are flagged, because their dates are only requests.
- Rescheduling one supplier prompts a review of the others in the same group.
- Customer or job dates update from the constraint, as described in the available to promise guide.
6. Use Shipping Notices and Receipts to Close the Loop
Shipping notices
Some suppliers send a notice when goods leave, either as an EDI ship notice or as a portal or email dispatch confirmation. It tells you what is coming and when, before it arrives. Record it against the order lines it covers, so goods-in can prepare and the buyer can see a shortfall days earlier.
Receipts and invoices
What actually arrived is recorded at goods-in on a goods received note. Comparing the shipping notice with the receipt shows whether differences arose at dispatch or in transit. The receipt then feeds invoice checking through three-way matching.
| Record | Source | What it tells you |
|---|---|---|
| Confirmation | Supplier | What the supplier agreed to supply |
| Shipping notice | Supplier | What the supplier says it sent |
| Goods received note | Your goods-in team | What actually arrived |
| Invoice | Supplier | What the supplier is billing |
Supplier bank details also arrive through this channel. Handle any change through a verified process, as set out in the supplier bank details change process, rather than accepting it as part of normal order correspondence.
7. Share Performance Data With Suppliers
Define a few measures precisely
Supplier conversations go better when both sides look at the same numbers. Keep the set small and write down each definition, including which date counts as on time and what tolerance applies.
| Measure | Definition to agree |
|---|---|
| Confirmation rate | Orders confirmed within an agreed number of working days |
| On time | Line received on or before the confirmed date, or within an agreed window |
| In full | Line received at the confirmed quantity, within any agreed tolerance |
| On time in full | Both conditions met on the same line |
| Change rate | Lines where the supplier revised the confirmed date after confirming |
HYPOTHETICAL worked example: one quarter’s record
Assume a supplier received 20 orders containing 50 lines in a quarter. 18 orders were confirmed within 2 working days. Of the 50 lines, 42 arrived on time, 45 arrived in full and 39 arrived both on time and in full. Seven lines had a supplier date revision after confirmation.
| Measure | Calculation | Result |
|---|---|---|
| Confirmation rate | 18 / 20 | 90.0% |
| On time | 42 / 50 | 84.0% |
| In full | 45 / 50 | 90.0% |
| On time in full | 39 / 50 | 78.0% |
| Change rate | 7 / 50 | 14.0% |
On time in full is lower than either measure on its own, because some lines failed on one condition only. All figures are hypothetical. Share the line-level detail with the supplier, not just the percentages, so both sides can check the same events. To decide which suppliers deserve this level of review, see our guide to supplier relationship management software. For measuring lead time itself, use the supplier lead time guide, and for incoming quality, the guide to supply chain quality management software.
8. Compare Approaches and Pilot With a Few Suppliers
Match the approach to the gap
| Approach | Where it fits | What to check |
|---|---|---|
| Configure current tools | Your accounting or inventory system has unused confirmation or date fields | Line-level confirmed dates, version history, reporting |
| Connect existing systems | Supplier responses arrive in one tool and plans live in another | Shared order references, error handling and reconciliation |
| Packaged supplier portal or EDI service | Suppliers will use a standard portal or already exchange EDI | Supplier onboarding, partner mapping, edition features and total cost |
| Focused custom application | A clear gap, such as multi-supplier coordination linked to jobs | Data access, support, maintenance and integration scope |
| Full ERP, packaged or custom | Wider finance, stock and planning needs justify broader change | Migration, configuration, delivery capacity and continuity |
Packaged portals and EDI services provide well-tested messaging and many businesses are well served by them. A custom application can follow an unusual process closely but needs support and maintenance arrangements. Compare options on the same scenario and include licences or hosting, implementation, supplier onboarding, training and ongoing support.
Script a pilot
Choose three to five suppliers that represent your mix: one on email, one willing to use a portal and, if relevant, one on EDI. Ask each option to demonstrate:
- Send an order and record the channel and version.
- Receive an acceptance with changes on two lines and route the differences for decision.
- Raise a buyer-initiated reschedule and record the supplier’s counter-proposal.
- Show a group of orders for one need with the constraint supplier highlighted.
- Record a shipping notice, then a short receipt against it.
- Produce the quarter’s supplier measures from line-level data.
Mark each step as demonstrated, configurable, requiring development or unsupported. The pilot passes when buyers stop keying the same response twice, planners use the latest accepted version and suppliers can see the same record you do.
Frequently Asked Questions
What is supplier order management software?
It is software that manages the exchange with suppliers about orders you have placed: sending orders, recording confirmations, handling changes from either side, tracking shipping notices and coordinating deliveries from several suppliers.
How is it different from a purchase order tracking system?
A tracking system follows your open order lines internally: what is due, overdue or part received. Supplier order management covers the conversation that keeps those dates and quantities accurate. Many systems do both, but it helps to test each job separately.
Do small suppliers need to use a portal or EDI?
No. Email remains practical for occasional suppliers, provided the buyer records each response as structured data on the order. Reserve portals and EDI for suppliers where volume justifies the setup.
What should happen when a supplier confirms with changes?
Compare the confirmation with the order line by line, then accept, reject or negotiate each difference. Only accepted changes should update the confirmed dates, quantities and prices your plans rely on.
How should schedule changes be recorded?
As numbered versions of the order, each with the requester, the reason and the response. Keep earlier versions so you can see how often dates moved and why.
How do you coordinate several suppliers for one job?
Link every order line to the job or customer order it serves. The latest confirmed date among them sets the earliest start, so expedite that supplier first and consider deferring early deliveries from the others.
What supplier performance measures should we share?
Start with confirmation rate, on time, in full and on time in full, using written definitions both sides accept. Share the line-level data behind each figure.
Can OpsMavix build supplier order management software?
Yes. OpsMavix can build focused applications or a full custom ERP, and can configure or integrate suitable existing tools where those approaches fit the requirements.
How OpsMavix Can Help
OpsMavix can map how orders, confirmations, changes and deliveries move between your team and your suppliers, then define the system scope needed to keep both sides working from the same record.
That may involve improving existing tools, connecting supplier responses to your planning records, building inventory automation that uses confirmed inbound dates, a wholesale order management system that promises customers from accepted supplier commitments, manufacturing production tracking that links jobs to the suppliers they depend on, or developing a full custom ERP.
Contact OpsMavix with one recent supplier confirmation or schedule change, the records behind it and the handoff that creates the most rework. We can use that evidence to define requirements and a practical pilot.
